Change Control

Change control software

Record the reason and the impact, get named sign-offs before work starts, and keep documents and training in step.

For pharma and life sciences quality teams replacing paper change forms and Excel logs, and working to FDA 21 CFR Part 11, EU GMP Annex 11 and Revised Schedule M. Each change keeps its reason, impact, signatures, tasks and audit trail on one record.

The problem

The change went live before the documents and training caught up

On paper, a change is a form in a folder, an approval in an e-mail and a training list nobody updated. When an inspector asks why it changed, who agreed it before it happened and what else it touched, you end up searching all of them. Complere brings change control into your eQMS, with one record for each change and one list for all of them.

What is change control?
Impact written late

Write down the impact first

The reason, impact and cost sit on the request the approver signs.

See how it works
Work before approval

Hold the tasks until quality releases

Nobody can sign a task until quality releases the change.

See how it works
Follow-through

See what is still open

The request waits at Implement Changes until every task closes.

See how it works
Inspection questions

Answer from one record

The reason, signatures, tasks, links and audit trail all sit on the request.

See how it works

Follow one change from the request to the sign-off

5 minutes 32 seconds on real product screens, with a demo record and fictional people. Short on time? Jump to the chapter you care about.

Running time

Chapters

Read the transcript

0:00 The problem: a change nobody can trace

On a line, in a lab, or in a clinic, things have to change: a procedure, a form, a machine setting. The trouble is how the change gets made: an e-mail that says just update step five, an edited copy in a shared folder, the old version still taped to the wall, a training list nobody updated. The change goes live, people keep following the old way, and only then does someone ask what else it touched. A procedure was changed. Why was it changed, who approved it before it happened, and what else did it touch?

0:29 What change control means, and one list for every change

Change control means nothing controlled changes until the reason, the impact and the sign-offs are on record. In Complere, each proposed change is a change request, and they all sit in one list. Each row shows how far it has come.

0:46 The route a change follows

In regulated work, a change needs named people to sign it before work moves on. In Complere, a change request follows a set route. Assess: the person running it signs the assessment. Approve: a named approver agrees, and quality releases it for work. Implement: the tasks get finished, and the request waits until they are. Sign off: quality reviews the finished work. Check: when quality calls for a check, the team proves it worked, and quality verifies. Closed.

1:15 One example: CC-1, raised from a CAPA

Here is one: CC-1, the rewrite of the gowning procedure, the steps staff follow to put on clean-room clothing. It came from a corrective action, CAPA-1, after two vials turned cloudy in a test run, traced to the order of those steps. Elena Fischer raised it, and the link back to that CAPA stays on the record.

1:37 What does it touch? Impact, cost and a risk score

Before anyone approves, Elena writes down what the change will touch: the reason, the impact and the cost. Here, procedure and training only: no equipment, no facility, and nothing to file with a regulator. About ninety person-hours. The form can also ask in a structured way: what changes before and after, which areas, how high the impact, and what type. You can also score the risk here, on a three by three, four by four or five by five matrix.

2:05 Who decided: the timeline and the sign-off settings

The timeline shows where this one has been. If a step is sent back, that shows here too, with the reason. Elena signed the assessment, and her note says the change lowers the risk to the product. Ingrid Weber approved it before any work began, and asked for the re-qualification to be planned. Then Farah Merchant, from quality, confirmed no regulator needed telling, and released it. You set who signs once. Their names fill in by group, and you decide how many must sign, and in what order.

2:34 The tasks inside it: owners, time limits and reminders

A change request is the whole decision, and each change is one task inside it, with its own owner, checker and due date. CC-1 has two. First, rewrite the procedure. Then, re-qualify everyone who works in that clean room: each person shows they can follow it, under observation. Elena signed the first and quality closed it. The second is still with Jake Morrison, waiting to sign, so the request waits at this step. Your team spends less time following up: each step can have a time limit, Complere e-mails reminders before and after the date, and anything late turns red on the dashboard and the list.

3:13 What it reached: the procedure and the training

The change reached other records, each showing its status today. The gowning procedure is now version two, with the old version kept. The training on it is its own record: Luis has finished, and Jake's is still open.

3:28 Tasks that close themselves

CC-1's two tasks are plain tasks, and you can make evidence compulsory before one closes. A task can also be a new document version: that task closes by itself when the version takes effect. Or a training: that task closes by itself when everyone named has finished. One task can also wait for another: it can't close until that one has. Closing a task doesn't close the request.

3:54 What's left before it closes

CC-1's timeline stops here, at today's status. The workflow shows what is left. One task of two is closed, and when the last one closes, the request moves to quality by itself. Quality signs off, and can call for a check that it worked. The tasks were the work; the check is the proof. For this change, that test sits with CAPA-1, and its runs under the new procedure are still to come. Closed is the last status on the route.

4:21 Every step kept: the audit trail

Every step is kept: who, what, when, and the note they signed with. Complere e-mails the people on the request as it moves, and those e-mails stay on the record too. That history is the audit trail, and it exports.

4:36 The answer, and what an inspector checks

The answer: it came from CAPA-1, to fix the order of the gowning steps. Elena Fischer assessed the impact: procedure and training only. Ingrid Weber approved it before any work began, and Farah Merchant released it. The rewrite is closed. The re-qualification is still open, so the request stays open, and the record says so. Every change raised, with its reason. Impact and risk looked at first. Approved before it happens. The work tracked to the end. Documents and training kept in step. Every step recorded, every sign-off signed. Change control you can show an inspector. See how one connected record can anchor your whole quality system. Request a demo.

Write down what the change touches before approval

Each change request holds the reason, the impact and the cost. This is CC-1, a demo record.

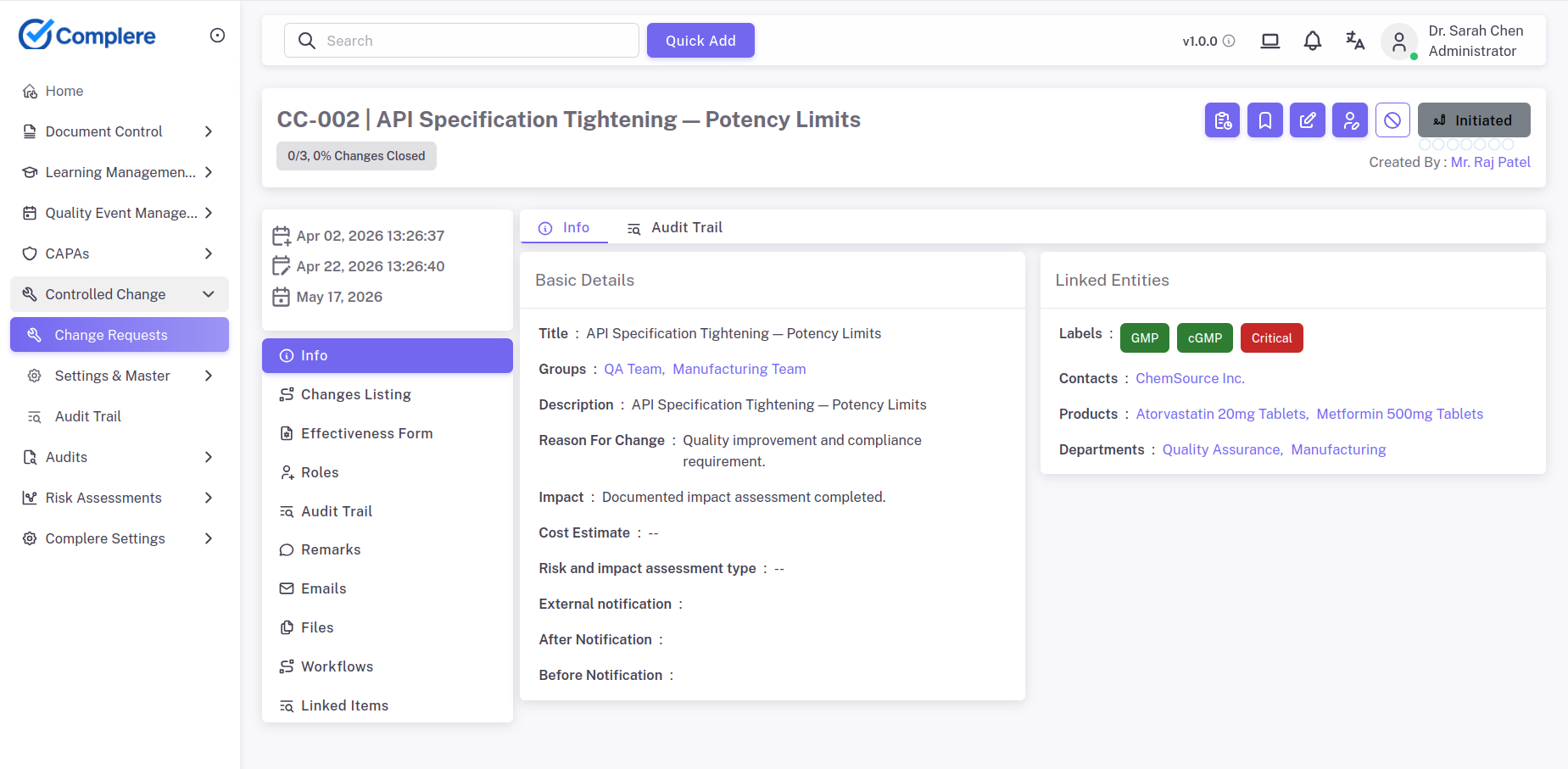

The CC-1 record at Implement Changes, Info tab: Basic Details with the title, groups, description, Reason For Change, Impact and Cost Estimate, beside the Linked Entities card. The impact reads procedure and training change only, no regulatory filing impact, 14 Grade B operators and 6 QC and validation staff affected. The cost totals about 90 person-hours.
CC-1, a demo record: the request, with its status, tabs and basic details.

The reason

CC-1: the procedure does not fix the donning order at the goggle and hood step. Link the change to the CAPA or other record behind it.

The impact

CC-1: procedure and training only, no regulatory filing impact, 14 Grade B operators and 6 QC and validation staff affected. Write the regulatory assessment here: who made it and the outcome. Quality confirms it in their signed note.

The cost

CC-1: no capital, about 90 person-hours in total. Put the cost where the approver reads it before signing.

The Impact section of the change request form in Multi Field mode: Affected Areas with Processes, Systems, Departments and Products; Impact Level with Minimal, Moderate and High; Type Of Impact with Quality, Compliance, Operational, Financial and Safety.

The Impact section of the form, in Multi Field mode.

Structured prompts

Ask the same questions on every change

Switch a section from a single field to several, and the form asks for what changes before and after, the areas affected, the impact level and the type of impact.

  • Suggested answers for the reason and impact prompts
  • The same choice for the description, reason, impact and cost
A 5 by 5 risk matrix on the change request form, with Severity across the top and Probability down the side, and cells from Low 1 to High 25. Open Text, 3 by 3 and 4 by 4 are the other choices.

The 5×5 risk matrix on the form.

Risk

Score the risk, if your SOP asks for it

Turn the option on, then record the risk as open text or on a 3×3, 4×4 or 5×5 risk matrix.

The route

Named people sign before any work starts

Each stage waits for its signature or its finished work. Signing re-checks the signer's password or single sign-on login. This is CC-1, a demo record.

The route of a change request from the film: Assess, Approve, Implement, Sign off, Check, Closed. Inside Implement, each task runs its own small route from In Progress through Awaiting QA sign-off to Closed. The request waits there, and moves on by itself when the last task closes.
The route a change follows, from the film. Each task runs its own small route while the request waits.
  1. Initiated card on CC-1: Elena Fischer signed as Coordinators on Sep 14, 2026, with the note that the impact assessment is complete and the risk to product is reduced by the change.

    1Initiated Coordinators

    The person running the change signs the assessment. Elena Fischer's note says the change lowers the risk to the product.

  2. Awaiting Approver sign-off card on CC-1: Ingrid Weber signed as Approvers on Sep 18, 2026, approving the change and asking for re-qualification to be planned.

    2Awaiting Approver sign-off Approvers

    A named approver agrees. Ingrid Weber approved it and asked for the re-qualification to be planned.

  3. Authorise Changes Implementation card on CC-1: Farah Merchant signed as QAs on Sep 21, 2026, with the note that no variation or notification is required and the change is released for implementation.

    3Authorise Changes Implementation QAs

    Quality releases it for work. Farah Merchant's note records that no variation or notification is required.

Send it back

A send-back needs a reason, and the reason stays on the timeline.

Add a review step

Add a preliminary reviewer if your SOP has that step.

Keep the detail

Each signature keeps the name, the role, the time and any note, and the card shows the time spent in that status.

Roles And Signature settings: the Coordinators card with the minimum number of sign offs required, beside the Default Coordinators and Default Approvers.

Roles And Signature settings: sign-offs on the left, default people on the right.

Who signs

Set who signs once

Default coordinators, approvers and QAs fill in on the form, and you set the minimum number of sign-offs for each role.

The request waits until every task is closed

A change request is the whole decision. Each change is one task inside it, with its own due date. A plain task also has its own owner and checker.

CC-1 at Implement Changes: one of two changes closed. CC-1-CHNG-1 is Closed and CC-1-CHNG-2 is In Progress. The product line reads: Waits for all 2 changes to close. When the last one closes, this change request moves to Awaiting QA sign-off by itself.

CC-1 at Implement Changes: one task closed, one in progress, and the product's own line on what happens next.

Open tasks

See which task is holding the request

Closing a task doesn't close the request. When the last task closes, the request moves to quality by itself.

  • Each plain task has a Coordinator who signs and a QA who checks
  • One task can wait for another: it can't close until that one has
  • Ask for evidence before a plain task goes to QA sign-off
The Change form with the Change list open: User defined, Make New Document Version Effective, highlighted, and Get Users Trained In Training.

The three kinds of task on the Change form.

Kinds of task

Let tasks close themselves

A task can be a plain task, a new document version or a training. The last two close by themselves while the request is at Implement Changes.

  • A document task closes once every linked document is effective
  • A training task closes once everyone named has finished
Workflow history of task CC-1-CHNG-1: In Progress, signed by Elena Fischer as Coordinators; Awaiting QA sign-off, signed by Farah Merchant as QAs; then Closed.

One task on CC-1: its own signed history.

One task

Each task keeps its own history

Open a task to see its details, owner, checker and every signature with its note.

See what the change reached

The request links to the records it touched, and each shows its status today.

The CC-1 record, Linked Items tab: a CAPA, Gowning-procedure ambiguity, Batch 24-117 media-fill contamination, and a Document, Aseptic Gowning Procedure, highlighted.
CC-1's Linked Items: the CAPA behind it and the procedure it changed.
The Versions list of SOP-001 with version 2.0 Published highlighted, earlier versions kept, and the person who saved each one.

SOP-001's versions: the new one published, the old ones kept.

Documents

The new version, with the old one kept

The procedure moves to its new version through Document Control, and earlier versions stay on the record.

How document control works
The Trainees list on TR-1, both rows highlighted: Jake Morrison No Progress and Luis Herrera Completed.

TR-1: Luis has finished, and Jake's training is still open.

Training

See who has finished the training

Training on the new version is its own record, with each person's status.

How training works

See which changes are running late

Each step can have a time limit, and Complere e-mails reminders before and after the date. A request past its due date shows a red Due flag on the dashboard.

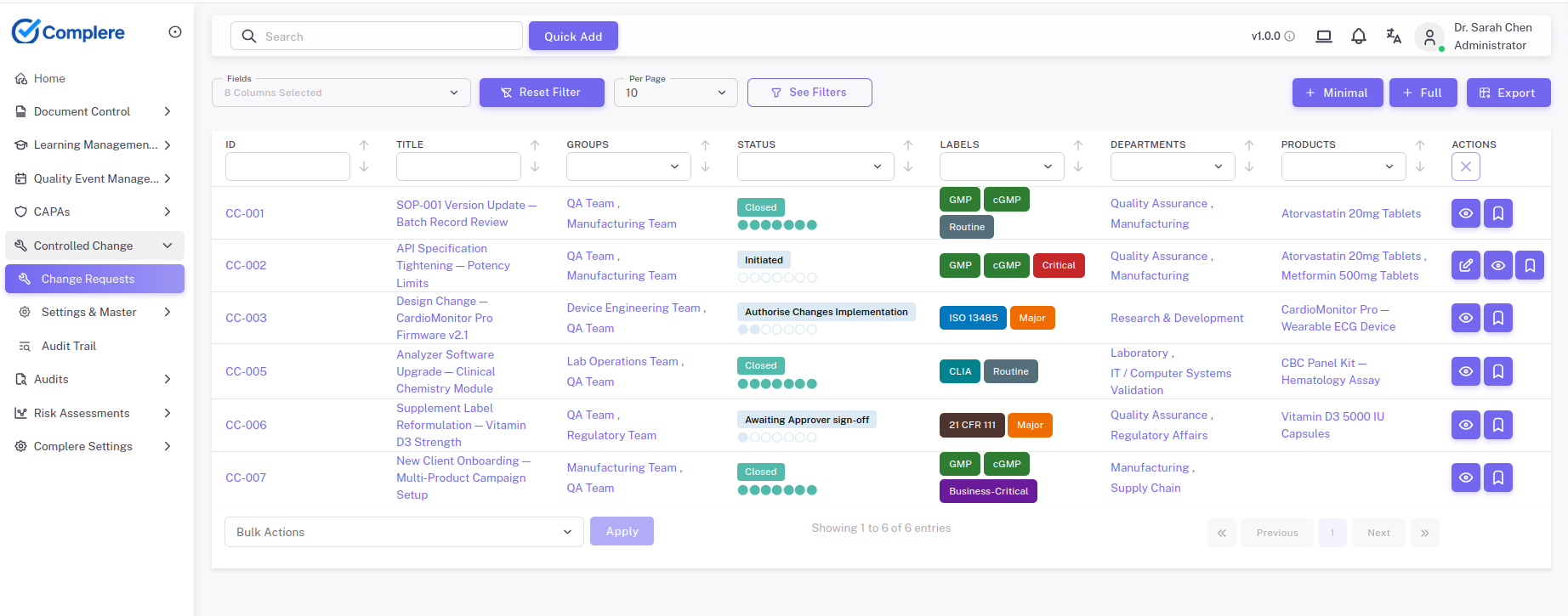

The Change Requests list with its Minimal, Full and Export buttons, and four demo records, CC-1 to CC-4, each with its title, groups, status and a row of progress dots.
The Change Requests list: each row shows how far the change has come.
Notification settings for before the due date: Recurring or Custom, when reminders start, how often they repeat, and the stop counter.

Reminder settings before the due date.

Time limits and reminders

Set time limits and reminders

Use one limit for every status, or a custom limit per status.

  • Set reminders before and after the due date, and how often they repeat
  • Complere e-mails the people on the request as it moves
  • Those e-mails stay on the record

Close it out, and check it worked

Quality reviews the finished work at Awaiting QA sign-off, and decides what happens next.

Quality signs off

Quality reviews the finished tasks, then closes the request or sends it on to an effectiveness check.

Check it worked

The Coordinator records the result on the Effectiveness Form. A Yes or Partially is signed and goes to quality's verification. A No goes back to quality.

Closed is the last status

The audit trail shows who closed it, and when. If your SOP allows reopening, it takes an electronic signature.

Six questions an inspector asks about a change

And where the answer sits in Complere.

Is each change on record, with its reason?

The Change Requests list, the reason for change and the linked CAPA.

Were impact and risk looked at first?

The impact on the request, and the signed note on the assessment.

Was it approved before it happened?

The approver and quality signatures, on the Workflows tab.

Was the work tracked to the end?

The Changes Listing tab: owner, checker, due date and date completed.

Were documents and training kept in step?

Linked Items, the new version and the training record.

Who did what, and when?

The audit trail, the Roles tab and the signatures.

These six questions are ours, based on EU GMP Annex 11 §10, Annex 15 §11 and Chapter 1, ICH Q9, ICH Q10 §3.2.3, 21 CFR 211.100 and ISO 13485.

The audit trail on CC-1 with its Export button and a highlighted row: Farah Merchant, as QAs, signed task CC-1-CHNG-1 from Awaiting QA sign-off to Closed, with her note and the date.
CC-1's audit trail: a signed move with its note, and the Export button.
  • A status moves on when the named role has signed (all holders, or the minimum you set), or by itself when the last task closes
  • A trail on each request, including its tasks
  • A module-wide view for Administrators and Managers
  • Export to CSV, Excel or PDF

Modules that work with change control

Link a change to the records around it, and hand it over as a report.

CAPA

Change how you work, for a reason

Link the change request to the CAPA behind it in Linked Items.

How CAPA Management works
Quality Events

Follow it back to the deviation

The deviation and its root cause sit in Quality Events, linked to the CAPA.

How Quality Events works
Training

Retrain the people affected

A task can close itself when everyone named has finished.

How training works
Reports

Hand over the change as a report

Report templates carry variables that fill from the record, and authorised users download it.

Set it up to match your SOP

An administrator sets the module up once in Settings, with no code. Start with one team, and add the rest when you are ready.

Change control Settings, General tab: the ID prefix CC-, then the options for Department, reopening of closed Change Requests, User Defined Fields, Linked Items, Products, Contacts, and the risk and impact assessment type.

General settings: your ID prefix, and the options you turn on.

Settings

Your prefix, fields and signers

Set your ID prefix, switch on the fields you need, and choose who signs and how many must sign.

  • Allow closed requests to reopen, if your SOP allows it
  • Set turnaround times, notifications and your report template
  • A permissions matrix shows who can do what at each status
  • Raise a change with the Minimal or Full form, or save it as a draft

Compliance, validation, go-live, pricing and your data

What a quality head asks before booking a demo.

Regulations

Working to GxP regulations?

Complere supports teams working to 21 CFR Part 11, EU GMP Annex 11, ALCOA+, ICH Q9, ICH Q10, ISO 13485 and Revised Schedule M.

See our compliance pages
Validation

The validation pack is included

Nine validation artefacts per module, aligned to GAMP 5 with a CSA risk-based approach, delivered on day one and included with the licence.

See what ships in the pack
Past records

Bring your past records with you

Import your paper and legacy records into Complere, and keep a record of exactly what came across.

How it works
Going live

Your scope sets the go-live date

We set up your environment in minutes, and your scope sets the go-live date.

See how the pilot works
Free pilot

Try it free for 3 months

A 3-month pilot on all eight modules, with item counts capped, for up to 10 users, with no licence fee.

Start with pilot
Pricing

Enterprise features at an affordable price

Built so small manufacturers and start-ups can use it too. Every plan includes the same audit trail, e-signatures and validation pack, and your quote is scoped to your team.

Compare plans
Your data

Your own database

Each customer gets its own database and storage bucket.

See the Trust Center

Frequently asked questions

What quality teams ask when they move change control off paper and Excel.

What is change control in Complere?

Change control means a proposed change is assessed, approved and recorded before it is implemented. In Complere, each proposed change is a change request. It holds the reason, impact, cost, signatures, tasks, linked records and audit trail.

Can work start before the change is approved?

Tasks can be drafted early, but nobody can sign one until quality releases the change, so the record shows the order things happened. Your SOP sets the rule your team follows on the floor.

Can a change close without an effectiveness check?

Yes. At Awaiting QA sign-off, quality decides whether the request goes to an effectiveness check or closes, and signs that decision. Your SOP sets the rule your team follows, and the audit trail shows which way each change went.

Where does the regulatory filing decision go?

Record the regulatory assessment in the impact: who made it and the outcome. Quality confirms it in their signed note when they release the change. In the demo record, CC-1 states no regulatory filing impact, and quality's signed note records that no variation or notification is required.

What happens when a change is sent back?

The person sending it back must give a reason. The request returns to an earlier status, and the reason stays on the timeline and the audit trail.

Who signs at each stage?

Initiators or Coordinators sign at Initiated, Approvers sign at Awaiting Approver sign-off, and QAs sign at Authorise Changes Implementation and Awaiting QA sign-off. If quality sends it to a check, Coordinators sign the effectiveness review and QAs sign the verification. Each plain task has its own Coordinators and QAs. You set the minimum number of sign-offs for each role in Settings.

What happens when the last task closes?

The request moves to Awaiting QA sign-off by itself, and the audit trail shows the move.

How do due date changes work?

Once the request leaves Initiated, the due date screen asks for a signature and a reason, and the change goes on the audit trail.

Can a closed change request be reopened?

Yes, if you turn on that optional setting. Reopening takes an electronic signature, and the audit trail records it.

What can we export?

The audit trail exports to CSV, Excel and PDF, and the change request list exports too. Authorised users can also download a report built from your report template.

Which regulations does Complere support?

Complere supports teams working to FDA 21 CFR Part 11, EU GMP Annex 11, ALCOA+ data integrity and GAMP 5. For pharma, that includes ICH Q9, ICH Q10 and Revised Schedule M. For medical devices, it includes ISO 13485, ISO 14971, FDA QMSR and 21 CFR Part 820. It also covers ISO 9001, and 21 CFR 111 for dietary supplements. Complere gives you the records, signatures and audit trail. Compliance stays with your site and your quality system.

Does Complere help with Revised Schedule M?

Complere gives your site the records for change handling: the reason, the impact, the signatures, the tasks and an audit trail. Meeting Revised Schedule M stays with your site and your quality system.

What happens to the changes in our Excel log?

Import your paper and legacy records into Complere. Enter them into our spreadsheet templates, check the results before anything goes live, and keep a record of exactly what came across.

Can we run one site or one team first?

Yes. Start with one site or team, and add the rest when you are ready. You can try this in the free 3-month pilot.

Bring your last change control to the demo

We will walk it through Complere with you, from the reason to the sign-off, or start a free 3-month pilot.
