CAPA Management

CAPA management software

Agree what success looks like before work starts, track every action to its due date, and keep the effectiveness check on the record.

For pharma and life sciences quality teams replacing Excel trackers and paper CAPA forms, and working to FDA 21 CFR Part 11, EU GMP Annex 11 and Revised Schedule M. Each corrective and preventive action keeps its plan, signatures, actions and audit trail on one record you can show an inspector.

The problem

The last task gets ticked, and months later the same problem is back

In a tracker, a CAPA is one row, an action list in an e-mail and a form in a folder. When an inspector asks who decided the fix and how you know it worked, you end up searching all of them. Complere brings CAPA management into your eQMS, with one record for each fix and one list for all of them.

What is a CAPA?
Success agreed late

Agree the test before the work

The approver signs the plan and the success criterion written into it.

See how it works
Late actions

See which actions are slipping

Each task has an owner, a checker, a due date and automatic reminders.

See how it works
Did it work?

Record the answer on the CAPA

The result, method, evaluation and evidence files stay on the Effectiveness tab.

See how it works
Inspection questions

Answer from one record

The plan, signatures, actions, links and audit trail all sit on the CAPA.

See how it works

Follow one CAPA from the signed plan to the effectiveness check

5 minutes 33 seconds on real product screens. Short on time? Jump to the chapter you care about.

Running time

Chapters

Read the transcript

0:00 The problem: the fix gets closed, and the problem comes back

On a line, in a lab, or in a clinic, problems get found: a failed test, a customer complaint, an audit finding. The trouble is where the fix lives: a tracker spreadsheet, an action list in an e-mail, meeting minutes, a shared drive, and the old system nobody fully trusts. The fix gets closed when the last task is ticked, and months later the same problem is back. A problem was logged, and a fix was promised. Who decided the fix, and was it done on time? And how do you know it worked?

0:29 One list for every fix

Some problems need more than a quick fix: a plan that removes the cause and stops it coming back. Complere keeps those plans in one list and calls them CAPAs, corrective and preventive actions. Each one is filed by kind: corrective, for a problem that happened; preventive, for one that could; or both. Each row shows how far it has come.

0:52 One example: CAPA-1, raised from a deviation

Here is one: CAPA-1, filed as both corrective and preventive. It started from a deviation, an event that went off plan: in a test run on a filling line, two vials turned cloudy with germs, and the investigation traced them to the order in which staff put on goggles and gloves. Marcus Chen raised the fix, linked it to that deviation, and wrote down the risk: high for patients, so the next batch waits until a stop-gap is in place and three test runs come back clean.

1:22 The route a CAPA follows

In regulated work, a fix needs named people to sign it before work moves on. In Complere, a CAPA follows a set route. Planned: the person raising it signs the plan. Approved: a named approver agrees, and quality gives the go-ahead. Done: the CAPA waits here while its actions get finished. Signed off: quality checks the finished work. Checked: when quality calls for a check, the team proves it worked, and quality verifies. Closed.

1:50 Who decided the fix, and the test for success

The timeline shows where this one has been. If a step is sent back, that shows here too. Marcus wrote the plan: rewrite the gowning procedure, and retrain everyone who works in that room, with a stop-gap in the meantime: a second person checks gowning at the airlock. Ingrid Weber approved the plan and the test for success, set before any work: three clean test runs in a row, and no warning results from staff at the gowning airlock. Then Grace Kim, from the quality team, gave the go-ahead to start the work.

2:20 The work: actions, owners and due dates

The plan became two actions, each with a due date. First, rewrite the gowning procedure. Then, plan the retraining of everyone in the room. A CAPA is the whole plan, and each action is one job inside it, with its own small route. The CAPA waits until the last one closes. Each action has its own owner and checker, and you can make evidence compulsory. Nobody can sign an action until quality gives the go-ahead. Sofia D'Souza signed the first, Priya Nair the second, and quality checked both. Both were closed on the fourth of October, before they were due.

2:54 What else an action can be

These two were plain tasks. An action can also be a new document version, which closes by itself when that version takes effect. Or it can be a training, which closes by itself when everyone named has finished. One action can also wait for another: it can't close until that one has.

3:14 What it changed: the procedure and the training

The work reached other records, each showing its status today. The gowning procedure, linked to this CAPA, went through a change request and is now version two. The second action only planned the retraining. The training on the new version is its own record: Luis has finished, Jake has not yet, so it stays open.

3:35 Quality signs off

The last one closing moved the CAPA on to quality by itself. Grace Kim checked the finished work and signed with a password: the new procedure released, the training to follow, and then the check that it all worked.

3:49 Did it work? The effectiveness check

Did it work? First, the test agreed at the start. The first results, under the stop-gap, met that test: no cloudy vials, and no warning results. But the runs after the new procedure are still to come, so the answer isn't final.

4:05 Where CAPA-1 stands today

CAPA-1's timeline stops here, at today's status. The workflow shows what is left: Marcus's review, then quality's verification. Signing the review locks the form, and a no would send it back to quality for another round. Once quality verifies it, CAPA-1 closes.

4:25 Every step kept: the audit trail

Every step is kept: who, what, when, and the note they signed with. That history is the audit trail, and it exports.

4:33 The answer, and what an inspector checks

The answer: Marcus Chen planned the fix, Ingrid Weber approved it with the test for success, and Grace Kim, from quality, gave the go-ahead. Both actions were done before they were due. The training itself is still running. Did it work? The first results say yes, under the stop-gap, and the final check stays open on the record until it is proven. A fix for every significant problem, with a date. Cause and risk understood first. The plan approved, with success defined up front. The work tracked to the end. A check that it worked, on the record. Every step recorded, every sign-off signed. Corrective and preventive action you can show an inspector. See how one connected record can anchor your whole quality system. Request a demo.

Write down what success means, and get it signed

Write the criterion into the plan or the signing note. The approver signs it, so nobody has to guess at the end what the fix was meant to achieve.

Signed approval on CAPA-1: Ingrid Weber, Approvers, signed on Sep 03, 2026 with the note Approved. The plan addresses both the procedural gap and the missing independent check. Effectiveness criterion agreed: three consecutive clean media fills and no airlock personnel-monitoring excursion in the review period.
CAPA-1, a demo record: the approver's signed note names the criterion, three clean media fills and no airlock excursion, before any work began.

Start from the problem

Link the CAPA to the quality event, audit or change behind it.

Get the plan signed

The person raising it signs, then a named approver, then quality gives the go-ahead.

Hold the work until then

Nobody can sign an action until quality gives the go-ahead.

CAPA-1 Basic Details: groups, title Gowning-procedure ambiguity, Batch 24-117 media-fill contamination, category Corrective and Preventive, risk and impact assessment type Open Text, and the written assessment of patient-safety, product and GMP impact, rated high

CAPA-1's written assessment of patient, product and GMP impact.

Risk and impact

Write down the risk on the CAPA

Record the risk and impact as open text, or score it on a 3×3, 4×4 or 5×5 risk matrix if you turn that option on.

  • File each CAPA as corrective, preventive or both, each with its own ID prefix
  • Tag the product, department, contact and label

Each task has an owner, a checker and a due date

A CAPA is the whole plan. Each action is one job inside it, with its own small route, and the CAPA waits until the last one closes.

View capa action CAPA-1-AXN-1: category Corrective, type User defined, the title and details of the procedure revision, due date 2026-10-06, Coordinators Sofia D'Souza, QAs Grace Kim, the option Evidence required during closure, and a workflow history from In Progress through Awaiting QA sign-off to Closed, signed at each step

One action on CAPA-1: the owner signs, quality checks, and the history stays with it.

Actions

Name who does it and who checks it

A plain task names its Coordinators, who do the work and sign, and its QAs, who check it and close it or send it back.

  • Turn on Evidence required during closure, and the owner must upload a file to sign the action
  • Make one action wait for another: it cannot close until that one has
  • Attach supporting files to each action
Add Action form: tentative ID, category Corrective or Preventive, and the Actions list open on User defined, Make New Document Version Effective and Get Users Trained In Training, beside the Title and Due Date fields

The three kinds of action on the Add Action form.

Less chasing

Some actions close by themselves

An action can be a plain task, or it can point at the work in another module, so nobody has to chase or re-key it.

  • Make New Document Version Effective closes when that version takes effect
  • Get Users Trained In Training closes when everyone named has finished
  • When the last action closes, the CAPA moves to Awaiting QA sign-off by itself, and the audit trail says so

See what is slipping before the review meeting

Set a due date on the CAPA and on each action. Reminders go to the people who own them, before the date and after it.

Get reminded

Set reminders before and after the CAPA's due date. Each open action also sends reminders the day before, on the day and for up to 3 days after.

Set a time limit per status

Turnaround Time sets one limit for all statuses or a limit for each, with "due tomorrow" and overdue reminders.

Filter to what is late

Filter a CAPA's actions to Not signed (Overdue) to see your own late signatures.

Record why a date moved

Moving an action's due date takes a password and a required reason.

See where time went

Each status card keeps the time spent there and any overdue time.

Show the dates on the list

Add Due Date and turnaround columns to the register, then export it.

CAPA register listing eight CAPAs with their IDs CA-1, PA-1 and CAPA-1 to CAPA-6, titles, and statuses such as Closed, Awaiting Approver sign-off, Implement Actions and Awaiting Effectiveness Review, each with progress dots

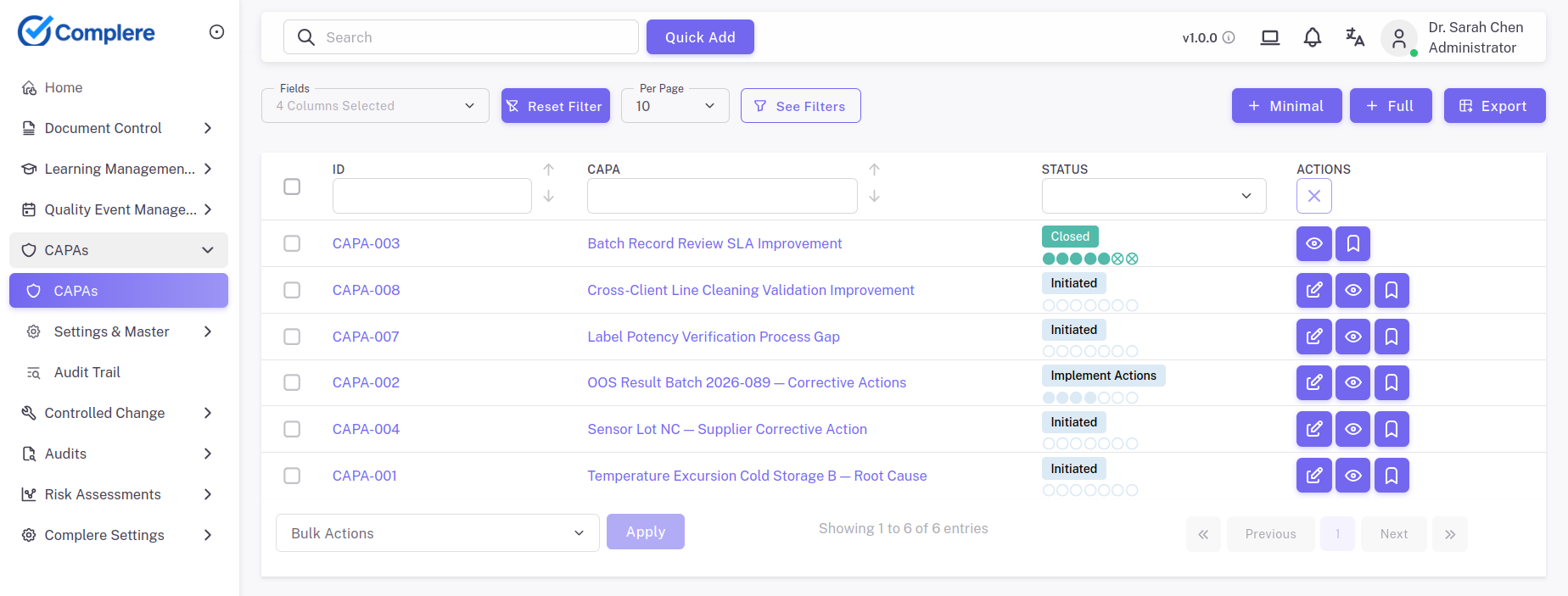

All CAPAs in one register, with their status and progress dots.

One register

Replace the tracker spreadsheet

Every open and closed CAPA sits in one list, and each row shows how far it has come.

  • Filter by status, category, group and more
  • Bookmark the CAPAs you follow

Did it work? Keep the effectiveness check on the CAPA

At Awaiting QA sign-off, quality decides whether the CAPA goes to an effectiveness check or closes, and your SOP sets the rule. A check then has two signed stages: the review, then quality's verification.

CAPA-1, Gowning-procedure ambiguity, Corrective and Preventive, status Awaiting Effectiveness Review, 2 of 2 actions closed: the Effectiveness tab with Was the action effective? set to Yes and a summary of the evaluation

CAPA-1's Effectiveness tab: the first results met the test, and the review stays open for the runs after the new procedure.

Effectiveness check

The result, the method and the evidence

The reviewer answers Was the action effective? with Yes, No or Partially, and adds the summary, the method, evidence files and the date.

  • Methods include Audit, Observation, KPI Review, Trend Analysis, Simulation/test run and Assessment
  • The first signature freezes the form
  • A No sends the CAPA back to Awaiting QA sign-off for another round, and the earlier evaluation stays on the record
Get the free effectiveness check form
The route

Named people sign at each stage

This is CAPA-1, a demo CAPA, on its real Workflows tab. The role beside a status is the one that signs while the CAPA sits there, and each card keeps the signer, the time, the note and the time spent in that status.

The route of a CAPA from the film: Initiated, Awaiting Approver sign-off, Implement Actions, Awaiting QA sign-off, Awaiting Effectiveness Review and Closed. Inside Implement Actions, each action has its own small route: In Progress, Awaiting QA sign-off, Closed. The last action closing moves the CAPA on by itself.
The route CAPA-1 follows, from the film. Each action runs its own small route while the CAPA waits.
  1. Initiated card: Marcus Chen signed as Initiators on Aug 31, 2026 with a note setting out the plan to revise the Aseptic Gowning Procedure and re-qualify Grade B personnel, with an interim control in place; 2 days 3 hours in this status

    1Initiated Initiators

    The person raising the CAPA signs the plan. Marcus Chen's note lists the two fixes and the stop-gap already in place.

  2. Awaiting Approver sign-off card: Ingrid Weber signed as Approvers on Sep 03, 2026 with a note approving the plan and agreeing the effectiveness criterion; 2 days 15 hours in this status

    2Awaiting Approver sign-off Approvers

    A named approver agrees the plan. Ingrid Weber's note records the criterion for success.

  3. Authorise Actions Implementation card: Grace Kim signed as QAs on Sep 06, 2026 with the note Implementation authorised; 3 days 6 hours in this status

    3Authorise Actions Implementation QAs

    Quality gives the go-ahead. Until this signature, nobody can sign an action.

  4. Implement Actions card: 2 of 2 actions closed, CAPA-1-AXN-1 and CAPA-1-AXN-2, each with its status and due date, above the line All 2 actions are closed, this CAPA moved to Awaiting QA sign-off by itself

    4Implement Actions Action owners

    The CAPA waits here while its actions get finished. Both of CAPA-1's closed before their due dates, and the last one moved the CAPA on by itself.

  5. Awaiting QA sign-off card: Grace Kim signed as QAs on Oct 05, 2026 with a note on the QA review of the procedure and the training to follow, ending Effectiveness check to follow; 17 hours 31 minutes in this status

    5Awaiting QA sign-off QAs

    Quality checks the finished work and signs, then sends the CAPA to an effectiveness check, as Grace Kim did here, or closes it.

  6. Awaiting Effectiveness Review card: Coordinators, Marcus Chen, not yet signed

    6Awaiting Effectiveness Review Coordinators

    The coordinator records whether it worked and signs. CAPA-1 is here today: the evaluation is saved, and the signature is still open.

  7. Awaiting Effectiveness Verification card: QAs, Grace Kim, not yet signed

    7Awaiting Effectiveness Verification QAs

    Quality verifies the review and signs.

  8. Closed card

    8Closed

    All signatures are in place, and nobody signs at this status.

Approvers and QAs can send a CAPA back to an earlier status with a required reason, and your SOP can add a preliminary review.

Six questions an inspector asks about a CAPA

And where the answer sits in Complere.

Is there a fix, with a date?

The register, and the due date on the CAPA and on each action.

Were cause and risk understood first?

The linked quality event, and the risk and impact assessment.

Who approved the plan?

The Workflows tab, with the signed note and the time.

Was the work done on time?

The Actions tab: owner, checker, due date and date completed.

Did it work?

The Effectiveness tab and its signatures, where quality sent the CAPA to a check.

Who did what, and when?

The audit trail, the Roles tab and the signatures.

Expectations drawn from 21 CFR 211.192, ICH Q9 and Q10, EU GMP Chapter 1 and Annex 11, 21 CFR Part 11, FDA QMSR (21 CFR Part 820, incorporating ISO 13485) and ISO 13485 §8.5.

Audit trail rows on CAPA-1: Grace Kim's signature moving the CAPA from Awaiting QA sign-off to Awaiting Effectiveness Review with her note, and a Status auto-advanced row recording that the CAPA moved from Implement Actions to Awaiting QA sign-off because all of its actions were closed

CAPA-1's audit trail: a signed move with its note, and the automatic move, labelled as automatic.

Audit trail

A history you can export

Immutable audit trail — database-enforced. Audit records cannot be modified or deleted, enforced by database-level constraints.

  • A status moves on when the named role signs, or by itself when the last action closes
  • The signature keeps their name, role, the time and any note they enter
  • A trail on each record, plus a module-wide view for Administrators and Managers
  • Export to CSV, Excel or PDF
See the FDA 21 CFR Part 11 and EU GMP Annex 11 controls

Keep the fix tied to what it changed

The deviation, the procedure and the training each keep their own record and status, and the CAPA links to them.

CAPA-1 header and Linked Items tab: the document Aseptic Gowning Procedure, is linked to, and the event Media-fill contamination, Batch 24-117, Grade B filling suite, is caused by

CAPA-1 links to the deviation that caused it and the procedure it changed.

Linked Items

See every linked record on one tab

Link a CAPA to records in Documents, Training, Quality Events, CAPAs, Change Requests, Audits and Risk Assessments.

  • For most linked modules, choose whether role users get an e-mail once the CAPA is closed
  • Each linked record keeps its own status and history
Trainees table on training TR-1, Aseptic Gowning Procedure rev 2.0, Grade B personnel: Jake Morrison, No Progress, and Luis Herrera, Completed, each with a due date of Nov 07, 2026

The training on the new procedure is its own record: one person finished, one still to go.

Live status

See who has finished

Training runs in its own module, so you see each person's status there.

How training works

Modules that work with CAPA

Link a CAPA to the records around it, and hand it over as a report.

Quality Events

Investigate the cause, and count repeats

The deviation, its root cause and the count of events per cause sit in Quality Events.

How Quality Events works
Change control

Change how you work, under control

Link a Change Request when the fix changes a process.

How change control works
Documents

Rewrite the SOP behind the cause

An action can close itself when the new version takes effect.

How document control works
Training

Retrain the people affected

An action can close itself when everyone named has finished.

How training works
Reports

Hand over the CAPA as a report

Report templates carry variables that fill from the record, and authorised users download it.

Set it up to match your SOP

An administrator sets the module up once in Settings, with no code. Start with one team, and add the rest when you are ready.

CAPA Settings, General tab: ID prefixes CA-, PA- and CAPA- for corrective, preventive and both, then the options Enable reopening of closed CAPA, Enable Department, Enable User Defined Fields, Enable Linked Items, Enable Products, Enable Contacts and Enable Risk and impact assessment type

General settings: your ID prefixes, and the options you turn on.

Settings

Your prefixes, fields and signers

Set the ID prefix for each kind of CAPA, switch on the fields you need, and choose who signs and how many must sign.

  • Add a preliminary review step if your SOP has one
  • Set turnaround times, notifications and your report template
  • A permissions matrix shows who can do what at each status
  • Raise a CAPA with the Minimal or Full form, or save it as a draft

Compliance, validation, go-live, pricing and your data

What a quality head asks before booking a demo.

Regulations

Working to GxP regulations?

Complere supports teams working to 21 CFR Part 11, EU GMP Annex 11, ALCOA+, ICH Q9, ICH Q10, ISO 13485 and Revised Schedule M.

See our compliance pages
Validation

The validation pack is included

Nine validation artefacts per module, aligned to GAMP 5 with a CSA risk-based approach, delivered on day one and included with the licence.

See what ships in the pack
Past records

Bring your past records with you

Import your paper and legacy records into Complere, and keep a record of exactly what came across.

How it works
Going live

Your scope sets the go-live date

We set up your environment in minutes, and your scope sets the go-live date.

See how the pilot works
Free pilot

Try it free for 3 months

A 3-month pilot on all eight modules, with item counts capped, for up to 10 users, with no licence fee.

Start with pilot
Pricing

Enterprise features at an affordable price

Built so small manufacturers and start-ups can use it too. Every plan includes the same audit trail, e-signatures and validation pack, and your quote is scoped to your team.

Compare plans
Your data

Your own database

Each customer gets its own database and storage bucket.

See the Trust Center
Help Center

Read how it works

Step-by-step guides for creating, signing and closing a CAPA.

Open the CAPA guides

Frequently asked questions

What quality teams ask when they move CAPAs off paper and Excel.

What is a CAPA in Complere?

A CAPA is a corrective and preventive action: the plan to fix a problem and stop it coming back. Each one is filed as corrective, preventive or both, and it holds the plan, the actions, the signatures, the effectiveness check and the audit trail on one record.

Can a CAPA close without an effectiveness check?

Yes. At Awaiting QA sign-off, quality decides whether the CAPA goes to an effectiveness check or closes, and signs that decision. Your SOP sets the rule your team follows, and the audit trail shows which way each CAPA went.

How do we record what success looks like?

Write the criterion into the plan or the signing note, so the approver signs it before work starts. In the demo record, the approver's signed note names the criterion: three consecutive clean media fills and no airlock personnel-monitoring excursion.

What happens if the effectiveness check fails?

The reviewer records No, and the CAPA goes back to Awaiting QA sign-off for another round. The earlier evaluation stays on the record. A Yes or Partially goes on to quality's verification.

Can Complere show repeat problems?

Repeat causes are counted in Quality Events: everyone files against one cause library, and each cause shows its Event Count. Link each CAPA to the event behind it, and you can follow a repeat cause through to the fix.

Where does the root cause analysis go?

In the quality event. The investigation, 5 Whys and cause sit on the event, and the CAPA links to it.

Which regulations does Complere support?

Complere supports teams working to FDA 21 CFR Part 11, EU GMP Annex 11, ALCOA+ data integrity and GAMP 5. For pharma, that includes ICH Q9, ICH Q10 and Revised Schedule M. For medical devices, it includes ISO 13485, ISO 14971, FDA QMSR and 21 CFR Part 820. It also covers ISO 9001, and 21 CFR 111 for dietary supplements. Complere gives you the records, signatures and audit trail. Compliance stays with your site and your quality system.

Does Complere help with Revised Schedule M?

Complere gives your site the records for CAPA handling: a signed plan, tracked actions, an effectiveness record and an audit trail. Meeting Revised Schedule M stays with your site and your quality system.

What happens to the CAPAs in our Excel tracker?

Import your paper and legacy records into Complere. Enter them into our spreadsheet templates, check the results before anything goes live, and keep a record of exactly what came across.

Who signs at each stage?

Initiators or Coordinators sign at Initiated, Approvers at Awaiting Approver sign-off, and QAs at Authorise Actions Implementation and Awaiting QA sign-off. Each plain task has its own Coordinators and QAs. Coordinators sign the effectiveness review and QAs verify it. You choose the signers, and you can add a preliminary review.

Can someone quietly move a due date?

Changing an action's due date takes a password and a required reason, and the change goes on the audit trail with the old and new dates.

Can a closed CAPA be reopened?

Yes, if you turn on that optional setting. Reopening takes a signature and a required reason, and the audit trail records it.

What can we export?

The audit trail exports to CSV, Excel and PDF, and the CAPA list exports too. Authorised users can also download a CAPA report built from your report template.

Can we run one site or one team first?

Yes. Start with one site or team, and add the rest when you are ready. You can try this in the free 3-month pilot.

Bring a CAPA that came back to the demo

We will walk it through Complere with you, from the signed plan to the effectiveness check, or start a free 3-month pilot.
